We are expanding our parking and interior to better serve the Lord!
SUMMARY:
Phases 1A & 1B — EXTERIOR WORK
Expand Parking and Create Storm Water Management Facilities
Phase 1A — Scope of Work:
1. Create additional parking in the rear of the church.
2. Create storm water management facilities.
Phase 1A — Cost Breakdown:
1. Erosion Sediment Control Measures: $19,000
2. Earthworks: $39,000
3. Stormwater Management (SWM) Facilities: $47,800
4. Utilities: $38,550
5. Demolition/Removal: $350
6. Parking Lot and Road Entrance: $23,300
Phase 1A — Total Cost = $168,000
Phase 1A — Improvements
1. We will go from 17 parking spaces to 34 parking spaces.
2. We will eliminate the swampy area between us and our neighbors.
3. The state-of-the-art underground drainage system and beautifully landscaped micro-bioretention facilities will take care of stormwater in an environmentally friendly way for years to come.

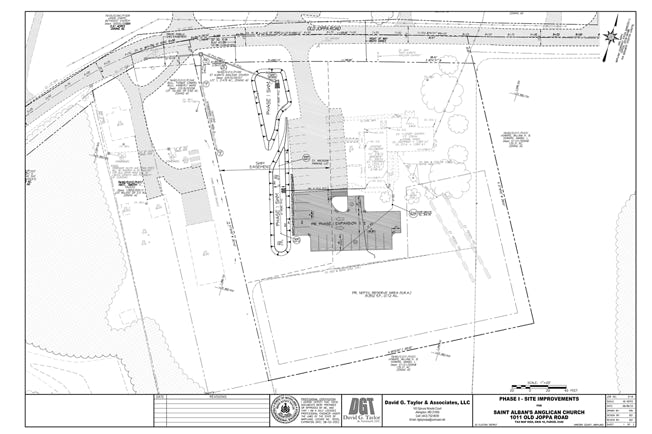

Tap on the picture below to see the plans for phase 1A!
Phase 1B — Scope of Work:
1. Create additional parking in the front of the church.
2. Create sidewalks, steps, etc.
Phase 1B — Cost Breakdown:
1. Erosion Sediment Control Measures: $4,800
2. Earthworks: $23,150
3. Stormwater Management (SWM) Facilities: $9,400
4. Demolition/Removal: $21,650
5. Flat Concrete: $26,000
6. Parking Lot and Road Entrance: $71,300
Phase 1B — Total Cost = $158,800
Phase 1B — Improvements
1. We will go from 34 parking spaces to 41 parking spaces. (We currently have only 17!)
2. We will have beautiful walkways, stairs, exterior lighting, and a new main entrance.
3. We will have gorgeous landscaping with spices native to our area.
Tap on the picture below to see the plans for phase 1A!
Here is a brief video on Phases 1A & 1B — the exterior work we have planned!
